You are here: Home » Blog » Data Center Raised Access Floor Selection Guide: Load, ESD, Airflow and Installation

Data Center Raised Access Floor Selection Guide: Load, ESD, Airflow and Installation

Views: 0     Author: Site Editor     Publish Time: 2026-09-04      Origin: Site

facebook sharing button
twitter sharing button
line sharing button
wechat sharing button
linkedin sharing button
pinterest sharing button
sharethis sharing button

In a data center, the raised access floor is rarely the first thing discussed during the design stage.

Racks, UPS systems, cooling equipment and power distribution usually receive most of the attention. The floor may only appear in the tender documents as a few basic specifications such as 600 × 600 mm, anti-static and Class A fire performance.

However, anyone who has worked on data center projects knows that flooring problems often do not appear on the day of installation.

Several months after equipment has been moved in, some panels may begin to move or wobble. As rack density increases, certain areas may experience insufficient airflow. More cable trays and services installed below the floor can change the original airflow pattern. After the data center becomes operational, on-site ESD test results may also differ from laboratory test reports.

These problems are rarely caused by a single floor panel.

More often, they result from treating the panels, pedestals, stringers, grounding system, perforated panels and installation work as separate components rather than as one complete system.

This becomes even more important as AI servers and high-density GPU racks become more common. Traditional data center flooring selection methods may no longer be sufficient.

The real question is not simply “Which raised floor has the highest load capacity?”

The more important questions are:

Can the complete floor system support the actual equipment load over the long term?

Can it work with the data center's cooling and airflow strategy?

And will the system remain stable and serviceable several years after installation?


A Data Center Raised Floor Is a System, Not Just a Panel

A raised access floor system may look simple.

There is a 600 × 600 mm panel on top, supported by pedestals and connected by stringers. In an actual data center project, however, the system involves much more.

The floor panel carries loads from racks, equipment and personnel. Pedestals transfer those loads to the structural slab. Stringers contribute to the overall stability of the system. The grounding system is important for electrostatic discharge control. The space below the floor may also be used for airflow distribution and cable management.

This means that the same floor panel can face very different engineering conditions depending on how it is installed.

A system installed at approximately 300 mm high in a conventional equipment room is not equivalent to the same panel installed at 600 mm in a high-density data center.

That is why a tender specification that simply says “600 × 600 mm anti-static raised floor” is usually not enough.

The specification should define the panel construction, load requirements, floor height, pedestal specifications, stringer configuration, ESD requirements and perforated panel requirements.

For high-load or high-floor-height applications, system stability and fixing requirements should also be clearly defined.

In other words, selecting a data center raised floor means selecting the entire support system, not just the panel.

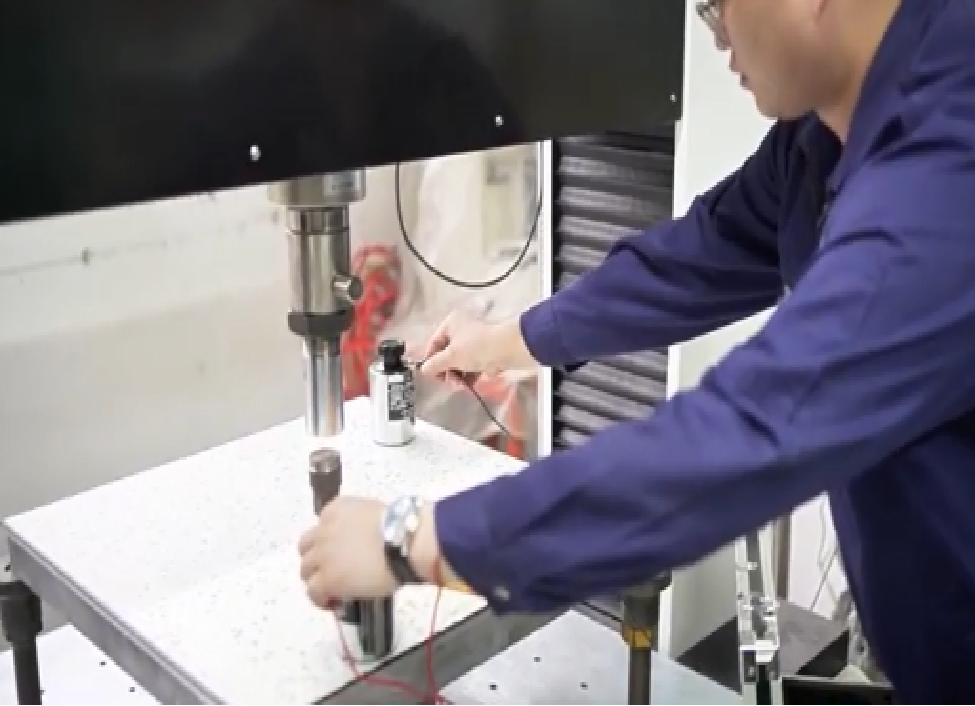

How Should Raised Floor Load Capacity Be Evaluated?

One of the most common mistakes in data center flooring selection is reducing load capacity to a single number.

A supplier may quote a concentrated load of 12,000 N, while another may state 1,000 kg. Without knowing how the tests were performed, these numbers cannot necessarily be compared directly.

For data center applications, at least three types of loading should be considered:

  • Concentrated load

  • Uniformly distributed load

  • Rolling load

Concentrated Load Matters for Rack Feet

The weight of a server rack is not evenly distributed across the entire 600 × 600 mm panel.

In most cases, the load is transferred through rack feet, casters or a base frame at several specific points. For heavy equipment areas, local loading can therefore be more important than simply comparing uniformly distributed load values.

There is another issue that is often overlooked:

Rack power rating and rack weight are not the same thing.

A 30 kW GPU rack does not automatically correspond to a specific raised floor load rating.

The actual calculation should consider the rack's own weight, the weight of internal equipment, the way the rack is supported and how the load is transferred into the raised floor system.

For particularly heavy GPU racks, UPS systems or battery cabinets, the floor may require denser pedestal spacing, reinforced supports or an independent load-bearing structure.

If the equipment weight approaches or exceeds the design range of a standard raised floor system, simply choosing a thicker panel is not always the best solution.

The load path itself may need to be reconsidered.

Rolling Load Can Be More Critical Than Static Load

After a data center is completed, servers still need to be moved into position. Several years later, equipment may need to be replaced or relocated.

Transport carts and equipment trolleys create moving loads as they pass over the floor. The same area may also experience repeated loading.

For high-density data centers, rolling load performance is therefore worth serious attention.

However, a supplier's statement such as “1,500 kg rolling load” or “2,000 kg rolling load” should not be evaluated in isolation.

Ask how the test was conducted.

What type of wheel was used?

What was the load per wheel?

How many cycles were performed?

What was the test path?

What residual deformation was allowed after testing?

Only when these conditions are clear does a rolling-load value have real engineering meaning.

ESD Performance Is More Than a Laboratory Test Report


Anti-static performance is a standard requirement for many data center raised floor projects.

The problem is that some projects treat a qualified surface resistance result as proof that the complete raised floor system will automatically meet the required ESD performance.

These are not necessarily the same thing.

Once installed, the floor panel, conductive components, pedestals, grounding connections and building grounding system together form the electrostatic discharge path.

If the panel itself performs well but the grounding connections are discontinuous or improperly installed, laboratory test results may not represent the actual condition on site.

During project acceptance, the test object and test method should therefore be clearly defined.

Depending on the applicable project standards, this may include surface resistance, system resistance and grounding continuity.

It is also not appropriate to simply assume that lower electrical resistance is always better.

Different standards, test voltages and test methods may specify different requirements.

A useful test report should clearly connect the product with the test method, test conditions and test results.

For the installation contractor, testing the completed system is equally important.

This is another reason why data center raised flooring should not be evaluated only by reviewing product test reports. Installation quality can directly affect the final performance of the system.

Fire Performance Should Be Evaluated on the Complete Floor


Data centers have strict fire-safety requirements, so raised access floors normally need to comply with the combustion or fire-performance requirements specified for the project.

There is a simple but important principle here:

Do not judge the final fire performance only by the core material.

Calcium sulfate, cement and steel each have their own material characteristics, but these characteristics do not necessarily represent the performance of the finished raised floor.

The complete product may also include the surface finish, bottom steel sheet and adhesives or other bonding materials.

For procurement, it is therefore better to review the test documentation for the actual finished product rather than determine fire performance simply from terms such as “cement-filled” or “calcium sulfate core.”

Both steel cement-filled raised floors and calcium sulfate raised floors are used in data center applications.

Steel cement-filled floors are often attractive for large-scale standardized data centers because of their mature construction and relatively predictable cost.

Calcium sulfate raised floors offer good dimensional stability, fire performance and acoustic properties, and may be considered for projects where long-term environmental and performance requirements are more demanding.

There is no single floor material that can be defined as the “best” without considering the actual project conditions.

Why Is Raised Floor Height Becoming More Important?

In older data centers, rack power densities were generally lower, and a raised floor height of around 300 mm could meet the requirements of many projects.

That situation is changing.

As high-density servers and GPU equipment become more common, some data centers require more space below the floor for airflow, cables and other MEP services.

But there is an important misconception to avoid:

A higher raised floor does not automatically provide better airflow.

The underfloor space is only part of the overall airflow and static-pressure system.

Whether sufficient cooling reaches the front of the racks depends on factors including HVAC airflow volume, static pressure, room size, rack power density, perforated panel open area and the arrangement of cables and services below the floor.

A 600 mm raised floor can still have poor airflow if the space below it is heavily congested with cable trays and other services.

For this reason, floor height should be determined according to the project's cooling and MEP requirements rather than applying a simple rule such as “all high-density data centers need 600 mm.”

Increasing floor height also means that pedestal stability needs to be reviewed.

As the pedestal becomes taller, its slenderness increases, and requirements for stringer connections, base fixing and resistance to lateral movement may become more demanding.

This is particularly important in areas subject to seismic design requirements.

Perforated Panels Often Have a Major Impact on Airflow


One of the most valuable functions of a raised floor in a data center is to use the underfloor plenum for air distribution.

However, the location of perforated panels is sometimes overlooked during the design stage.

Ideally, conditioned air should leave the floor directly into the rack intake area.

If a perforated panel is positioned too far from the rack or in an unsuitable location, cold air may enter a hot aisle or be carried away by the return-air system before reaching the server intake.

This can result in cooling-air short-circuiting.

The number of perforated panels and their open area should not be selected using a one-size-fits-all approach.

A conventional server area may require one configuration, while a high-density GPU rack area may require a completely different airflow strategy.

Perforated panel locations should therefore be coordinated with rack heat loads and the HVAC system. Where necessary, CFD analysis can be used to verify the airflow distribution.

This becomes even more important when hot-aisle or cold-aisle containment is used.

A well-designed data center does not necessarily need perforated panels across the entire floor.

Instead, conditioned air should be delivered where it is needed, while solid panels can be used in lower-demand areas to reduce unnecessary air leakage.

How Much Infrastructure Can Really Fit Under the Floor?

This is a problem that many projects discover during construction.

At the design stage, a 600 mm underfloor space may look like a large, open plenum.

After cable trays, power cables, fire protection pipes and other MEP services are installed, the space available for unrestricted airflow may be significantly reduced.

A high-density data center should therefore not treat the underfloor space as an empty cavity that can be used without limits.

The areas beneath rack air intakes should be kept as clear as possible.

Cable trays and other services should also be planned with airflow paths in mind.

When a data center has both a high cable density and significant underfloor cooling requirements, these elements should be coordinated during the design stage rather than resolved on site.

This is why raised floor selection should not be left entirely to the finishing contractor.

The architectural layout, HVAC system, MEP services and IT equipment arrangement are closely connected.

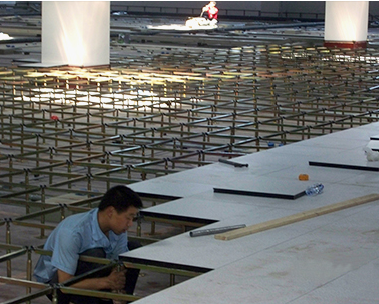

Pedestals and Stringers Determine Long-Term Stability

When a raised floor is newly installed, many systems can look almost identical.

The real difference may only become apparent after a year or more of operation.

If the pedestal system lacks sufficient rigidity, or if stringer connections are not properly installed, the floor may gradually develop minor movement, joint changes or local height differences.

These issues may not be obvious in a conventional low-height installation.

As floor height and equipment loads increase, however, the support structure becomes increasingly important.

For this reason, a technical evaluation should not focus only on panel thickness.

The material and specification of the pedestals, adjustment range, base fixing method and stringer connection should all be considered.

High-load areas may require reinforced pedestals or other load-bearing measures according to the engineering design.

Where seismic or lateral stability requirements apply, the system should be fixed according to the structural and seismic design requirements rather than relying on site workers to add reinforcement based only on experience.

Installation Details That Are Easy to Overlook

Raised floor installation may not appear particularly complicated, but many long-term problems start with small installation details.

For example, an uneven structural slab may be compensated for entirely through pedestal adjustment. Pedestals may not be securely fixed as required by the design. Some stringers may be missing or improperly connected. Panels may have noticeable height differences after installation. Wall edges and service penetrations may not be properly sealed.

These problems may not be obvious immediately after handover.

They can become more noticeable after racks are installed, equipment is moved across the floor and the cooling system begins operating continuously.

Project acceptance should therefore go beyond checking whether the floor surface looks neat.

Pedestal stability, panel level differences, stringer connections, grounding continuity and sealing around the underfloor space should also be inspected.

If underfloor air distribution is being used, airflow performance should also be included in the commissioning or acceptance process.

It is better to identify insufficient airflow before the servers are fully operational than after a rack begins running at full load.

Different Data Centers Require Different Floor Selection Strategies

A conventional IDC and an AI data center may both use raised access flooring, but their selection criteria are becoming increasingly different.

For conventional server rooms, steel cement-filled raised floors remain a mature and practical solution.

They offer a well-established supply chain and relatively predictable project costs, making them suitable for large-scale standardized installations.

For data centers with higher equipment density and more demanding requirements for load capacity, dimensional stability or environmental performance, calcium sulfate raised floors may also be considered.

AI and GPU data centers require a new evaluation of both load and airflow.

Traditional IDC parameters should not simply be copied.

GPU servers can result in higher rack weights, greater local floor loads and significantly higher heat loads.

For particularly heavy equipment, an independent structural support system may need to be considered outside the raised floor itself.

At the same time, liquid cooling is becoming increasingly common in high-density data centers.

With direct-to-chip or other liquid cooling technologies, some areas may rely less on traditional underfloor air distribution. However, raised floors can still provide useful space for cable management, equipment maintenance and infrastructure routing.

The role of the raised floor in future data centers may therefore extend beyond simply distributing cooling air.

It can become part of the broader infrastructure platform.

How to Choose a Raised Floor Supplier: Look Beyond the Quotation

When purchasing raised access floors for a data center, price and technical specifications are usually the easiest things to compare.

But if these are the only criteria, a project can easily end up with a supplier whose products look strong on paper but are difficult to manage in the field.

The more useful questions are:

Are the claimed performance figures supported by actual test reports?

What test methods were used?

Does the factory have sufficient production capacity?

Has the supplier completed similar data center projects?

How does the supplier handle technical issues during installation?

For large projects, production capacity and quality-control procedures should also be reviewed.

For international projects, packaging, transportation, technical documentation, project coordination and after-sales support also become important.

An experienced raised floor supplier will usually ask more questions before recommending a product.

For example, if a customer provides the rack weight, floor height and room area, an experienced supplier should not immediately recommend the floor with the highest load rating.

The supplier should also ask how the racks are supported, whether the underfloor space contains large cable trays, whether underfloor air distribution is being used and how perforated panels will be arranged.

That kind of communication is itself part of a supplier's engineering capability.

What Types of Data Center Projects Can Huilian Support?


Jiangsu Huilian's raised access floor product range includes steel raised access floors, calcium sulfate raised floors and ventilated floor panels.

Different combinations can be considered according to the project's load requirements, operating environment and budget.

Not every area of a data center needs the highest specification.

Standard rack areas can use a suitable configuration based on the design load, while heavy equipment areas can be reinforced separately.

For data centers using underfloor air distribution, the floor system should also be coordinated with perforated panels and the hot-aisle/cold-aisle layout.

This project-based approach is often more practical than simply recommending one standard product for the entire facility.

Huilian has experience supplying raised access floor solutions for research facilities, smart manufacturing and data infrastructure projects, as well as projects in markets including Europe, the Middle East and Southeast Asia.

For a data center project, customers can provide more than just a basic request such as “600 × 600 mm anti-static raised floor.”

Providing information such as rack weight, floor height, underfloor functions, load requirements, cooling requirements and project location will generally allow the supplier to develop a more accurate solution.

When Should Raised Floor Design Start?

Ideally, raised floor requirements should be considered well before the finishing stage.

A data center raised floor affects architectural planning, HVAC, MEP services and equipment layout. The earlier these requirements are coordinated, the fewer modifications are likely to be needed later.

At the early design stage, at least three questions should be clarified:

How heavy are the racks and other major equipment?

Will the underfloor space mainly be used for airflow, cable routing, or both?

What cooling and hot-aisle/cold-aisle strategy will the data center use?

Once these conditions are clear, the required floor height, pedestal system, panel construction and perforated panel configuration can be properly evaluated.

If the floor is considered only after equipment has been finalized and cable trays have already been installed, there may be very little room for adjustment.

What Is Changing in Data Center Raised Floors in 2026?

In the past, raised floor selection for data centers mainly focused on three factors:

Load capacity, ESD performance and airflow.

These requirements remain important, but they are no longer enough to describe the complete engineering challenge.

AI computing is increasing rack weight and heat loads. Liquid cooling is changing traditional airflow strategies. At the same time, data centers are placing greater emphasis on energy efficiency, sustainable materials and lifecycle management.

As a result, future raised floor systems will increasingly be evaluated as integrated infrastructure systems.

The panels need to carry loads.

The pedestals need to remain stable.

Perforated panels need to work with the cooling system.

The grounding system needs to remain reliable.

Materials need to perform consistently over long service periods and, increasingly, be considered from a sustainability and recyclability perspective.

Some advanced projects are also beginning to explore the integration of temperature, humidity, pressure or leak-detection monitoring into floor infrastructure.

These technologies are not standard requirements for every data center today, but the direction is becoming clear:

Raised access floors are gradually moving from a building finishing component toward an integral part of data center infrastructure.

Conclusion: Choose the Floor Around the Project, Not the Other Way Around

The difficult part of selecting a data center raised access floor is not the number of products available.

It is the complexity of the project itself.

A conventional server room, a high-density computing facility and an AI/GPU data center can have very different requirements for loading, cooling and maintenance.

Even within the same data center, different areas may not need exactly the same floor configuration.

So instead of asking:

“Which raised floor is the best?”

Start with a few practical questions:

How much do the racks weigh?

What functions will the underfloor space serve?

What floor height is actually required?

How will the HVAC system deliver cooling air?

Where will perforated panels be installed?

How will heavy equipment loads ultimately be transferred?

What are the project's ESD, fire-performance and seismic requirements?

Once these conditions are clear, the appropriate panel structure, pedestal specification and overall system configuration become much easier to determine.

The same principle applies when selecting a supplier.

The supplier with the highest numbers on a quotation is not necessarily the best choice.

A more valuable partner is one that can connect test data, product structure and actual engineering conditions, and is willing to take responsibility for the result delivered on site.

That is what should really be compared when selecting a raised access floor system for a data center.

Contact us

MOQ ≥100㎡

Contact HUILIAN Support Team

*Please feel free to contact us. Our sales team will follow you as soon as possible.
Contact us

MOQ ≥100㎡

Expert Raised Floor Manufacturer  |  20+ years Experience
Professional R&D and Quality Inspection Team  |   Wide Range of Products
Products
Why HUILIAN
Case
© COPYRIGHT 2024 JIANGSU HUILIAN ACTIVITY FLOORING CO., LTD. ALL RIGHTS RESERVED.
